Collection
Major HS2 motorway works planned across the West Midlands in 2026 – Key information
Find all our HS2 information for motorway works in one place. This includes advanced notifications, diversion routes and further information.

M6 and M42 closures June to November
We will be carrying out a series of major engineering works over the M42 and M6 between June and November 2026. These works are required so that we can install three new railway structures for Britain’s new high-speed railway.
M42 between junctions 6 to 9 northbound and 9 to 7 southbound
We previously advised that our next weekend closure to continue the M42 works will be over the M42 from 23 to 26 October.
The Met Office is forecasting that large parts of the UK will be affected by strong winds this weekend (23 – 25 October), so we’re making some changes to our planned programme of construction works to ensure we keep everyone safe.
The Water Orton viaduct parapet installation works that were planned to take place above the M42 will be rescheduled. As a result, J6 to 9 northbound and J9 to 7 southbound will be open this weekend.
We plan to complete the works over the M42 the following weekend (subject to weather conditions) from 9pm on Friday 30 October until 5am Monday 2 November 2026.
M42 J7 link to M6 northbound
There will be work on the M6 J4a southbound link to the M42 in both directions and temporary restrictions between M6 J3a to T1 northbound and from T2 southbound from 5am on Saturday 24 October until 10pm Sunday 25 October.
M42 weekend closures between J6 to 9 northbound and J9 to 7 southbound – HS2
Planned closure dates
The current programme of weekend closures is as follows:
| Dates | Works | Status |
| 26–29 June 2026 | First beam installation for the M42 twin-box structure | complete |
| 24–27 July 2026 | Water Orton viaduct installation and continued M42 beam works | complete |
| 14–17 August 2026 | Continued Water Orton and M42 installation works | complete |
| 21–24 August 2026 | M6 South Viaduct West deck slide | complete |
| 18–21 September 2026 | Final M42 beam installation and viaduct works | complete |
| 24–25 October 2026
30 October – 2 November 2026 | M6 South Viaduct West deck slide
Water Orton viaduct parapet installation |
The current programme of weekend closures is as follows:
All dates remain subject to consent and operational requirements.
Find out more
We will be holding a series of community information events in collaboration with National Highways to help residents, businesses and commuters understand the works and prepare for the closures.
These events will provide:
- Details of planned motorway closures
- Information on diversion routes
| Date | Venue | Times |
| Wednesday 8 July | Martson Green Village Hall | 2pm until 6pm |
| Thursday 9 July | Balsall Common | 2pm until 6pm |
| Thursday 9 July | Birmingham Business Park | 11.30am until 2pm |
| Tuesday 14 July | Webinar | 1pm to 2pm |
| Tuesday 14 July | Chelmsley Wood Three Trees | 10am until 2pm |
| Thursday 16 July | Chelmsley Wood Onward Club | 4pm until 8pm |
| Thursday 16 July | Aldi Coleshill | TBC |
| Saturday 18 July | Dordon Village Hall | 10am until 2pm |
| Saturday 29 August | Sheldon Fire Station | 10am to 3pm |
| Thursday 20 August | Marston Green Village Hall | 10am to 3pm – TBC |
For details visit our Events webpage
Plan ahead before you travel
Plan ahead before you travel
You will still be able to reach your destination. Please follow the fully signed diversion and allow extra time for your journey.
For real-time updates on roadworks and closures, including HS2 activities on public highways, visit one.network.
Our works

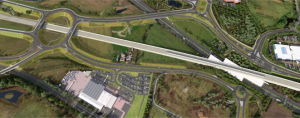

M42 twin-box structure
Once complete, the 300-metre-long M42 twin-box structure will allow trains to travel above the motorway while vehicles continue through the box below.
Engineers will install 175 individual beams weighing between 56 and 92 tonnes across four weekend closures.
The structure has been designed using modular construction techniques, allowing much of the work to be completed without closing the motorway.

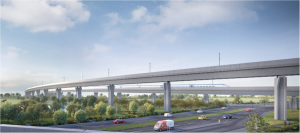

Water Orton viaduct installation
In nearby Water Orton, engineers are preparing to extend two viaducts that will carry high-speed trains towards Birmingham Curzon Street and the Washwood Heath rolling stock depot.
Rather than building the final sections using traditional cantilever methods, the remaining viaduct spans will be assembled beside the motorway and moved into place using self-propelled modular transporters.
This innovative approach significantly reduces installation time and minimises disruption for motorists.
Works are scheduled to begin on Friday 24 July 2026.

M6 South Viaduct West
The final major operation involves installation of the M6 South Viaduct West near Chelmsley Wood.
Using a fully restrained deck-slide process, engineers will move the viaduct into position while keeping traffic moving during key phases of the operation.
