Skip to main page content

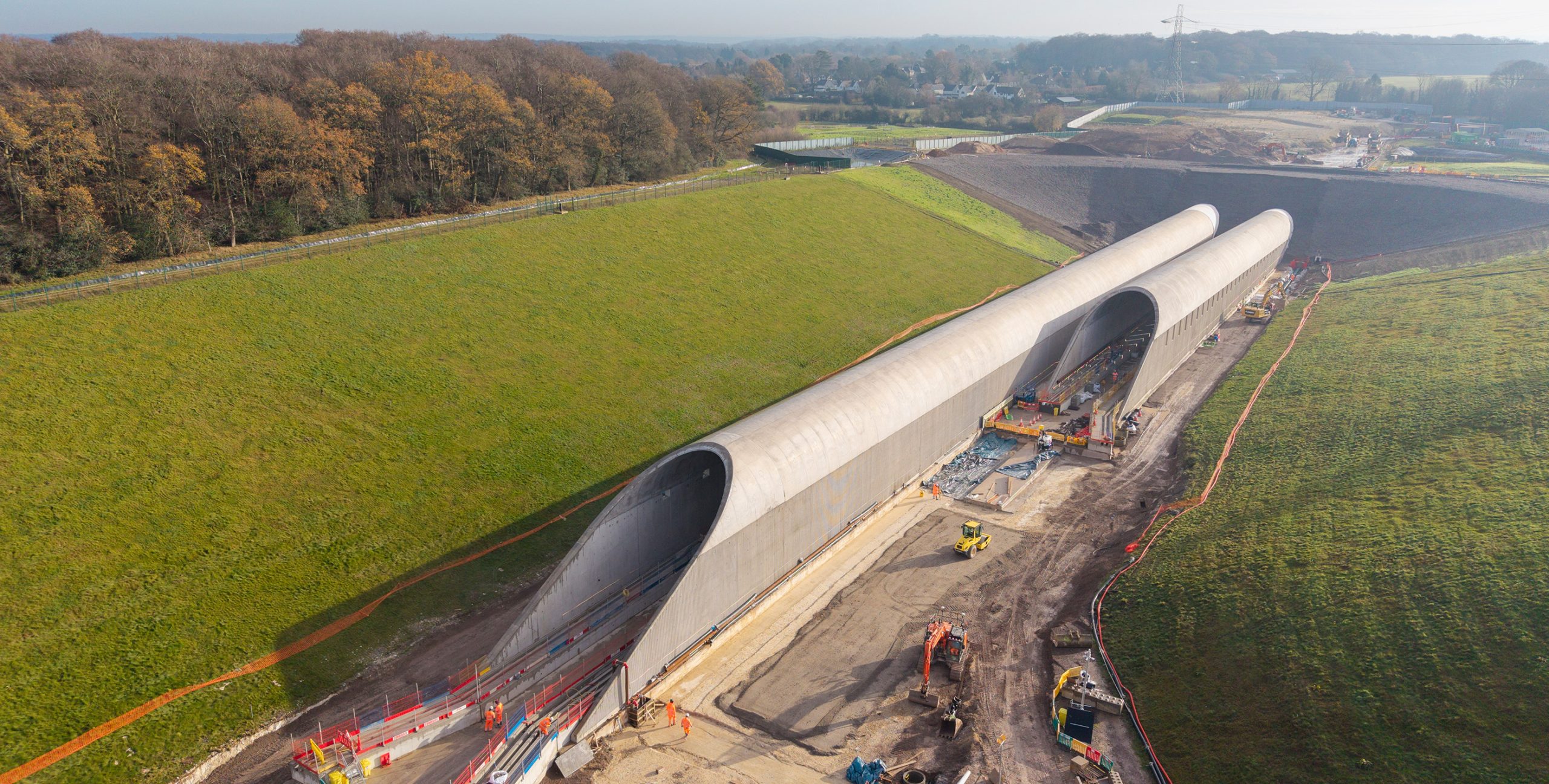

View inside an HS2 rail tunnel.
View inside an HS2 rail tunnel.

Twin-bore tunnels

A twin-bore tunnel is where two parallel tunnels, each containing a single rail track, are constructed using Tunnel Boring Machines (TBMs).

In total, high-speed trains will travel through over 27 miles of twin-bore tunnels – or almost a fifth of the 140-mile route. This means that HS2’s fleet of tunnel boring machines (TBMs) are excavating and building a total of 55 miles of bored tunnel.

  • Bromford Tunnel: 3.5 miles (5.8 km)
  • Long Itchington Wood Tunnel: 1 mile (1.6km)
  • Chiltern Tunnel: 10 miles (16km)
  • Northolt Tunnel: 8.4 miles (13.6km)
  • Euston Tunnel: 4.5 miles (7.3km)



Most of HS2’s tunnels are being built by TBMs, which have huge rotating cutterheads which excavate on average around 15 metres each day.

The rotating cutter-head at the front of the TBM bores the tunnel, installing the round concrete segments that form the tunnel walls as it goes.

As well as digging through earth and rock, the TBMs build the tunnels themselves. These subterranean moving factories slot and secure thousands of concrete segments into position, creating the cylindrical corridors for the high-speed trains.

82%

Twin-bore tunnels

Our fleet of tunnel boring machines have excavated over 82% of HS2's deep underground tunnels, creating over 45 miles of tunnel to date.

Over four-fifths (82%) of the mining for the giant network of HS2 tunnels is complete.

Our longest and our shortest tunnels – the 10-mile Chiltern tunnel and the 1-mile Long Itchington Wood tunnel – are both structurally complete, with base slabs, cross passages, concrete finishing and walkways installed.

Tunnelling is also complete on our second longest tunnel – the 8.4-mile Northolt tunnel – with the last of four TBMs used to dig the tunnel completing its journey on 26 June 2025.  Work is ongoing inside the tunnel on the cross passages, tunnel fit-out and surface structures.

HS2 currently has one active tunnelling machine – TBM Elizabeth, which is mining the second drive of the 3.5-mile Bromford tunnel in Birmingham.  It is expected to complete its journey later this year.

Preparatory works are underway to launch the final pair of HS2 tunnel boring machines (TBMs) that will build the fifth and final structure – the Euston tunnel – that will take HS2 to Euston in the heart of the capital.

Twin-bore tunnelling progress

Bromford Tunnel, Birmingham

In the Midlands, TBM Mary Ann has completed the first bore of the 3.5-mile Bromford Tunnel, between Water Orton in North Warwickshire and Washwood Heath in Birmingham. ‘Elizabeth’ is due to breakthrough later this year.

100%

TBM Mary Ann

TBM Mary Ann completed its drive of the 3.5-mile Bromford Tunnel on 9 May 2025, when it arrived in the tunnel's Washwood Heath portal in Birmingham.

72%

TBM Elizabeth

TBM Elizabeth is second tunnel drive of the Bromford Tunnel in Birmingham and has so far completed over 2.6 miles of her 3.5 mile tunnel drive.

Long Itchington Wood Tunnel, Warwickshire

One tunnel boring machine, TBM Dorothy, was used to construct both bores of the 1-mile Long Itchington Wood tunnel.  The first drive was completed in July 2022 and the second drive completed in March 2023.

100%

TBM Dorothy

TBM Dorothy completed its first drive of the one-mile tunnel drive in July 2022 and the second in March 2023, when it arrived in the tunnel’s south portal in Warwickshire.

Chiltern Tunnel, Buckinghamshire

The 10-mile Chiltern Tunnel is the longest tunnel on the HS2 route.  Two tunnel boring machines, ‘Florence’ and ‘Cecilia’, were used to create the tunnel.  The machines completed their historic 10-mile journeys in February and March 2024 respectively, breaking through at the tunnels north portal near South Heath, Buckinghamshire.

100%

TBM Florence

TBM Florence completed its 10-mile (16km) tunnel drive on the 27 February 2024, when it arrived at the Chiltern Tunnel north portal in Hertfordshire.

100%

TBM Cecilia

TBM Cecilia completed its 10-mile (16km) tunnel drive on the 21 March 2024, when it broke through at the Chiltern Tunnel north portal in Hertfordshire.

Northolt Tunnel, London

In London, four tunnel boring machines (TBMs) were used to create the 8.4-mile Northolt Tunnel. TBM’s Sushila and Caroline dug the five-mile western section, travelling from West Ruislip on the outskirts of the capital to Green Park Way in Greenford, north-west London. Two more machines – ‘Emily’ and ‘Anne’ were used to dig the 3.4-mile eastern section of the tunnel, mining from Victoria Road in Ealing to Green Park Way.

100%

TBM Sushila

TBM Sushila completed its tunnel 5-mile drive on 19 December 2024, when it reached the Green Park Way vent shaft in Ealing.

100%

TBM Caroline

TBM Sushila completed its tunnel 5-mile drive on the western section of Northolt Tunnel in London on 3 April 2025, when it reached the Green Park Way vent shaft in Ealing.

100%

TBM Emily

TBM Emily completed its tunnel 3.4 mile drive on the eastern section of the Northolt Tunnel in London on 6 June 2025, when it reached the Green Park Way vent shaft in Ealing.

100%

TBM Anne

TBM Anne completed its tunnel 3.4 mile drive on the eastern section of the Northolt Tunnel in London on 26 June 2025, when it reached the Green Park Way vent shaft in Ealing.

Future tunnel drives

Euston Tunnel, London

Preparatory works are underway to launch HS2’s final pair of giant tunnelling machines.  They will be used to dig the Euston Tunnel – the final 4.5 miles of underground high-speed railway carrying HS2 trains into the heart of London.

The two 190m-long TBMs, ‘Karen’ and ‘Madeleine’, were transported to Old Oak Common in West London in pieces in 2024, before being reassembled on site.  They are now being reassembled at the eastern end of the station, and prepared to launch to Euston next year.

Our twin-bore drives

Euston Tunnel

Euston Tunnel

Euston Tunnel is a 4.5 miles (7.3km) that will take passengers from Euston station to Old Oak Common station.

Northolt Tunnel

Northolt Tunnel

Northolt Tunnel is a 8.4miles (13.6km) tunnel under London that will take passengers from Old Oak Common to West Ruislip.

Chiltern Tunnel

Chiltern Tunnel

The longest and deepest tunnel will be the Chiltern Tunnel measuring 10 miles (16km) long and will go as deep as 90 metres.

Long Itchington Wood Tunnel

Long Itchington Wood Tunnel

A short 1 mile (1.6km) long tunnel under Long Itchington Wood, preserving this ancient woodland.

Bromford Tunnel

Bromford Tunnel

Bromford Tunnel 3.5 miles (5.8km) that will take trains into Birmingham as they approach Curzon Street Station in the heart of the city.
