Skip to main page content
Still of the South Portal Chiltern Tunnels exterior and interior

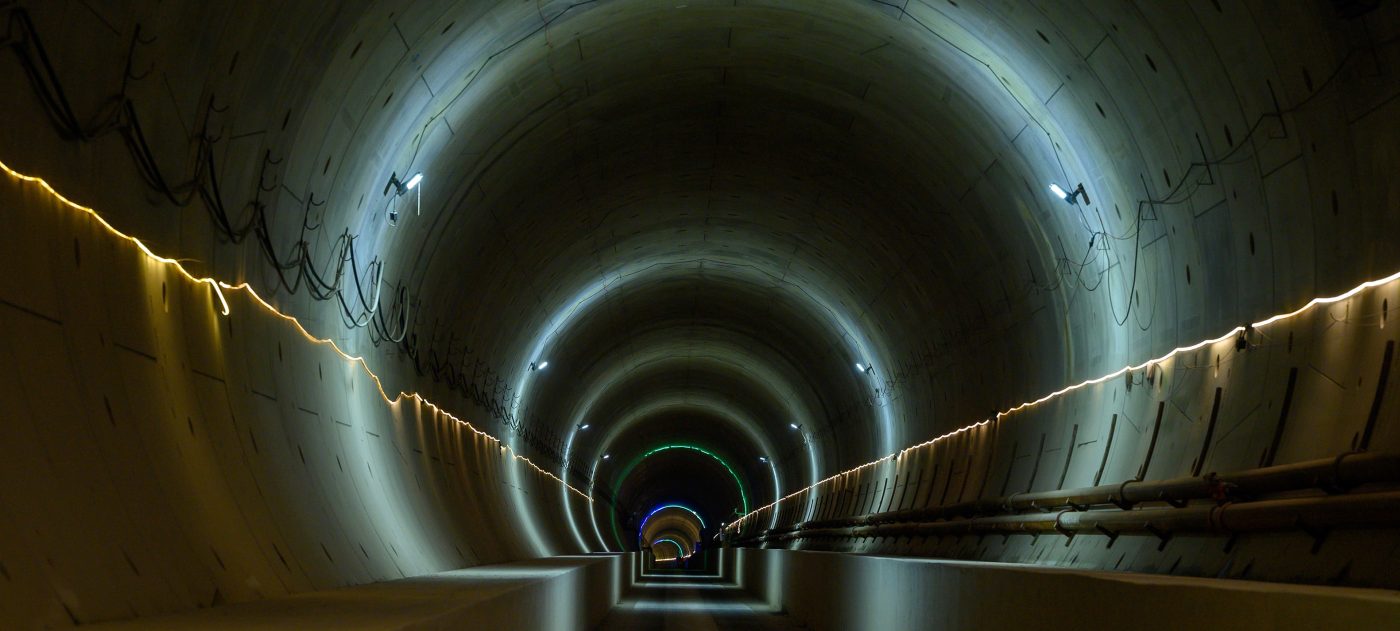

The interior of the Chiltern Tunnel looking out to the south portal.

Chiltern Tunnel

The Chiltern Tunnel is the longest tunnel on the HS2 route, stretching 10 miles (16km) beneath the Chiltern Hills. Two TBMs, Florence and Cecilia, were used to excavate the twin-bore tunnel. TBM Florence completed her journey in February 2024, followed by TBM Cecilia in March 2024.

Tunnel construction

The enormous 2,000 tonne tunnel boring machines were built in a factory by world-leading German tunnelling specialists Herrenknecht. After completion the machines were disassembled before beginning their long journey to England. On arrival at site, they were reassembled by the entrance to the tunnels, where a specially prepared head wall allowed them to safely begin their excavation.

Designed specifically for the geology of the Chilterns, each machine is a self-contained underground factory; digging the tunnel, lining it with concrete wall segments and grouting them into place as it moves forward. A crew of 17 operatives keep the machines running, working in shifts, and supported by over 100 people at the main compound, managing the logistics and maintaining the smooth progress of the tunnelling operation.

Each of the separate northbound and southbound tunnels will require 56,000 precision engineered, fibre-reinforced concrete wall segments – which are all being made at the south portal of the tunnel, next to the M25.

Approximately 2.7 million cubic metres of material will be excavated during the construction of the tunnels and used for landscaping around the south portal site. Once construction is complete, this will help create around 90 hectares of wildlife-rich chalk grassland habitats. Chalk grassland used to be widespread across the hills of southeast England and are considered habitats of international conservation significance with just 700 hectares left across the Chilterns.

Chilterns South Portal Chalk Grassland Project

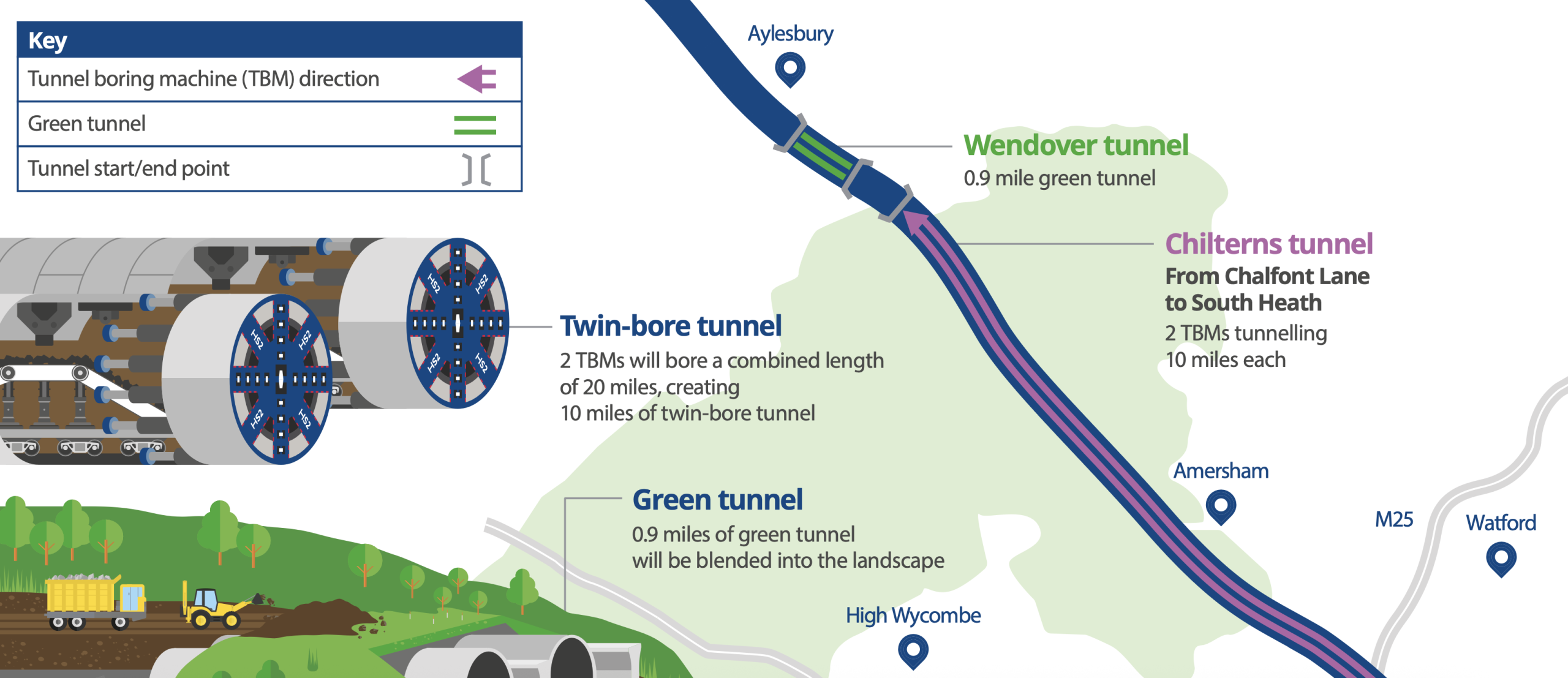

Discover our tunnels in Buckinghamshire

Buckinghamshire tunnels map graphic
Buckinghamshire tunnels map graphic

Cross passage construction

Construction of HS2’s longest tunnels begun a new phase with the start of work on thirty-eight cross passages, between 15 and 20 metres in length, linking the northbound and southbound tunnels.

An expert team of miners used a remotely controlled excavator to break out of and excavate from one tunnel to the adjacent tunnel. As the excavation is progressed the ground is supported using a sprayed concrete lining (SCL). Once this is complete, a water-proof membrane is installed followed by a secondary concrete lining.

Once a passageway is complete, the safety doors can be installed at either end. Each running tunnel has an emergency walkway that allows passengers to safely evacuate the train and walk through the cross passages into the other tunnel where they can be rescued on a passenger train. Access for emergency services is from either the portal or one of the five ventilation / emergency access shafts.

Did you know...

Chiltern Tunnel facts and figures

  • Tunnel length: 10 miles (16km)
  • Tunnel elevation: 110m
  • No of tunnel cross passages: 38
  • No of tunnel ventilation shafts: 5
  • Tunnelling construction: 112,000 segments
  • Tunnelling excavation: 2.7 million m³

Chiltern Tunnel - key construction milestones

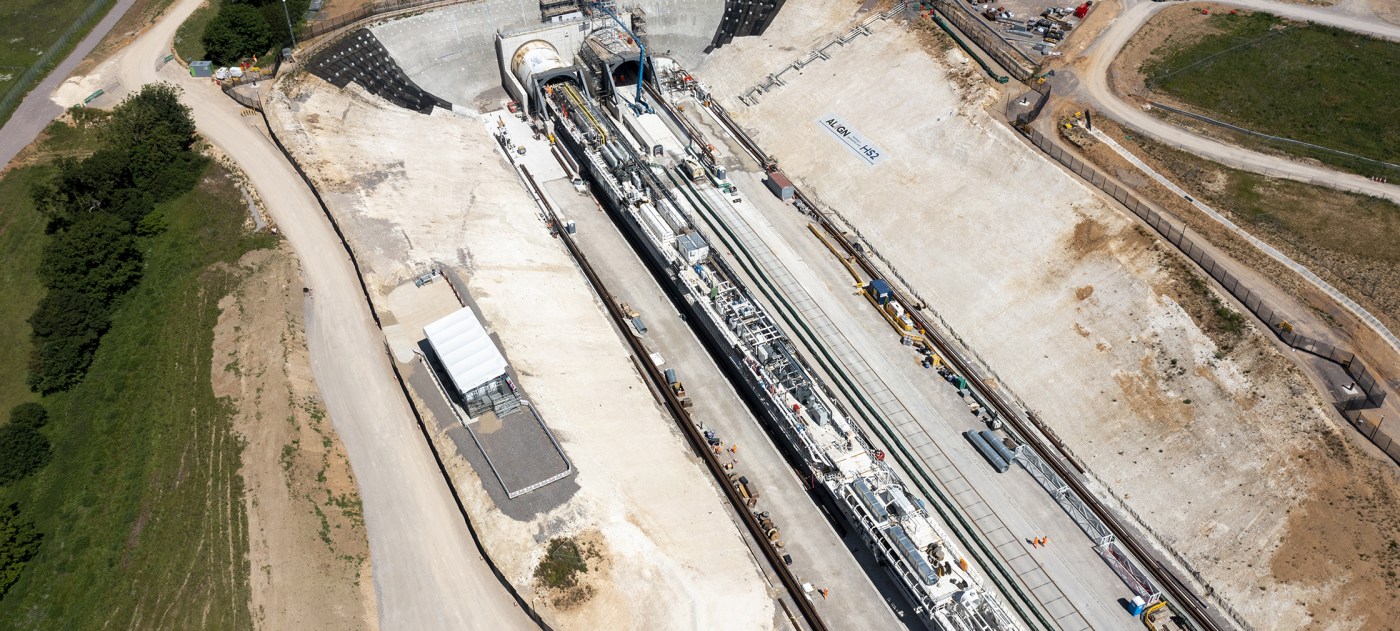

The first tunnel boring machine building the Chiltern Tunnel, named Florence, is launched

May 2021 Find out more

The second tunnel boring machine building the Chiltern Tunnel, named Cecilia, is launched

July 2021 Find out more

First mile of the 10 mile Chiltern Tunnel completed

Sept 2021 Find out more

First of 38 cross passages that will link the north and south bound tunnels completed

August 2022 Find out more

Both TBMs pass halfway mark

February 2023 Find out more

The first tunnel boring machine to be launched, Florence, completes her drive

February 2024 Find out more

The second tunnel boring machine to be launched, Cecilia, completes her drive

March 2024 Find out more

Construction of the north porous portal is underway

October 2024 Find out more

Chiltern Tunnel Ventilation Shaft & Headhouses

Chiltern Tunnel South Portal

Chiltern Tunnel South Portal

On the approach to the portal, 90 hectares of chalk grassland will form the largest scheme in our Green Corridor programme.

Chalfont St Peter

Chalfont St Peter

Set back from the road, the building is topped with a simple grey zinc roof, its doors and vents picked out in dark bronze for contrast.

Chalfont St Giles

Chalfont St Giles

Set into a fold in the Chiltern hills the headhouse takes its inspiration from the style of nearby barns and other agricultural buildings.

Amersham

Amersham

Sitting just outside Amersham, the weathered steel wall will be swapped for flint, a stone long used in Chiltern architecture.

Little Missenden

Little Missenden

Dark, neutral tones and a palette of zinc, brick and steel take cues from local farm and industrial buildings.

Chesham Road

Chesham Road

The building’s colour and detailing blend into the landscape, using a simple palette inspired by local farm and industrial forms.

Chiltern Tunnel North Portal

Chiltern Tunnel North Portal

A simple single-storey building clad in earth-toned zinc will house equipment, its green roof helping it blend into the landscape.
